Preston Western Distributor and East-West Link Road

Sign up for updates

Latest update

We are building a major new road - the Preston Western Distributor, which will link Preston and southern Fylde to the M55 motorway.

Scheduled to open early in 2023, this £200m road scheme is the biggest new road programme in the Preston, South Ribble and Lancashire City Deal.

It will help to promote new housing and business development in the area, while increasing capacity on the existing local road network.

The Preston Western Distributor will link the A583 and the M55 motorway and will involve the construction of:

  • a new motorway junction
  • four new bridges, and
  • three underpasses

The scheme also includes two new roads connecting to new and existing housing areas of North West Preston and Cottam. The new East-West Link Road and Cottam Link Road will provide convenient access to the Preston Western Distributor, avoiding already congested local routes.

Plan ahead - road closures for works

Temporary closure of Sandy Lane and permanent closure of Maxy Lane

A section of Sandy Lane will remain closed until the end of March to allow the construction of the new junction on EWLR. Motorists will be required to divert via the signed diversion along Hoyles Lane and Tabley Lane. There is no access for pedestrians or cyclists through the road closure.

During closure, full access will be available to the businesses at Maxy Farm (Ashbridge Nursery, The Salon at Maxy Farm and The Pantry at Maxy Farm) from Hoyles Lane only. Maxy Lane will be permanently shut between Sandy Lane and Cherry Tree Farm. There will be no access for vehicles or pedestrians after this time and the road will not reopen.

Tabley Lane

Work to construct the new junction on Tabley Lane will commence once Sandy Lane reopens; the new junction will link Tabley Lane to the new EWLR. Access along Tabley Lane will be available with temporary traffic lights in place from March until August 2021.

Temporary Closure of Harbour Lane

Harbour Lane will be closed until May 2021 to construct the new Lea Lane alignment, which will join the new Saddle Roundabout. Pedestrian access will be available throughout the full closure.

Blackpool Road – First Phase

The first phase of the new roundabout at Blackpool Road will start very soon. Clearance and fencing works will commence towards the end of February on the south side of Blackpool Road, with the closure of one lane. A small section of the Guild Wheel footpath will also be closed with a diversion in place for pedestrians and cyclists. The construction of the south side is due to last until the beginning August 2021.

Temporary closure of Bartle Lane

Part of Bartle Lane is closed for construction on Bartle Lane Bridge and the stretch of the Preston Western Distributor Road through Bartle. A road closure is in place at approximately 240 metres from the junction of Lea Lane for safety reasons.

Motorists are required to divert via the signed diversion along Lea Lane, Sidgreaves Lane, Hoyles Lane and Sandy Lane (also operating in reverse). Pedestrians, cyclists and horse riders will not be able to travel through the road closure. Properties located on Bartle Lane can be accessed via Sandy Lane, but not Lea Lane.

It is expected that Bartle Lane will reopen in summer 2022 where traffic on Bartle Lane will travel over the Preston Western Distributor Road on the newly-constructed Bartle Lane Bridge.

Bartle Lane closure - diversion route



Permanent closure of Darkinson Lane to vehicles

Vehicles will no longer be able to use Darkinson Lane due to construction on the Darkinson Lane underpass. A road closure is necessary for safety reasons and diversions will be in place for both vehicles and non-motorised users (pedestrians, cyclists and horse riders).

Motorists will be required to divert via the signed diversion along Darkinson Lane, Lea Lane and Sidgreaves Lane (also operating in reverse). Pedestrians, cyclists and horse riders will be able to access Darkinson Lane, but will be required to follow a short, signed diversion around the works area. Properties and businesses located on Darkinson Lane itself have specific access requirements which have been communicated to those concerned.

It is expected that the new underpass will open by autumn 2021. Upon completion of the work, Darkinson Lane will not reopen to vehicles; pedestrians, cyclists and horse riders will be able to use the underpass.

Darkinson Lane closure

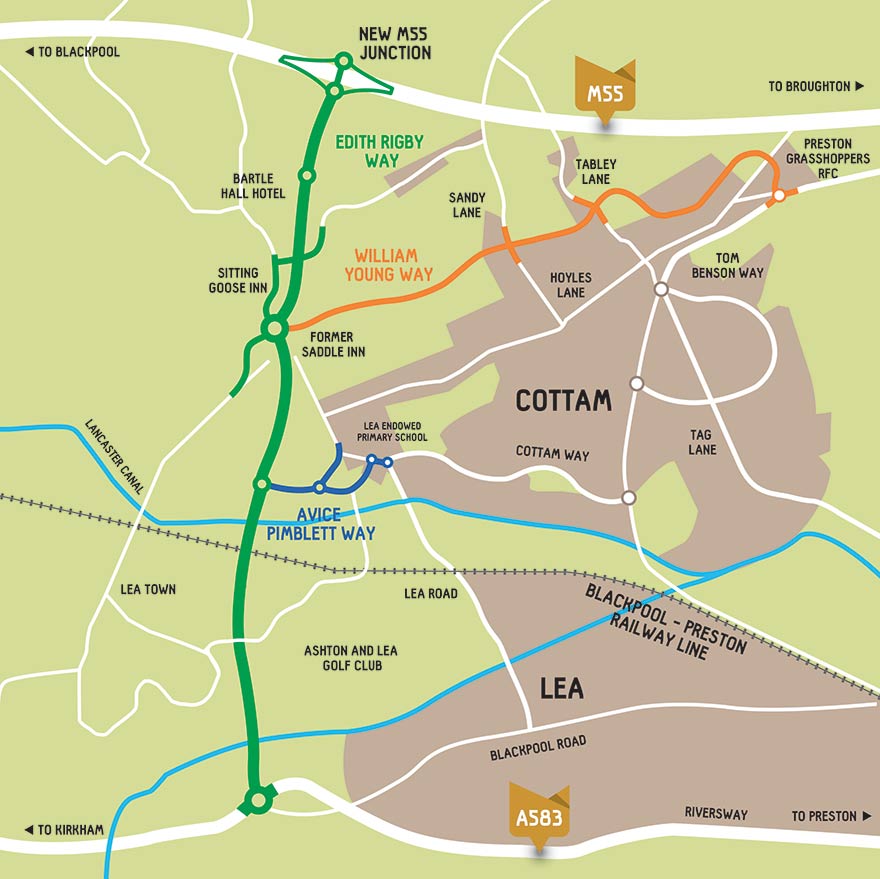

Map

Preston Western Distributor overview map

Fly-through

View the fly through of the route for the Preston Western Distributor.

Contacts

Our contractor Costain have two dedicated Community Relations Officers Sarah Sunderland and Billy Howorth who can be contacted with any queries about the scheme by email at PWDHelpline@costain.com or by calling 01772 808061. They aim to respond to any queries within two working days.

Construction started in September 2019.

These are the latest planned timescales to complete this road programme, as with any construction project of this scale, this timetable may be vary:

Work description Date
Ecological mitigation Early October 2019 - Summer 2020
Hodder Aqueduct diversion Early January 2020 - Summer 2020
Lea Viaduct construction Early January 2020 - Summer 2022
Savick Viaduct construction February 2020 - December 2022
Motorway Bridge Autumn 2020 - Autumn 2021
Lea Viaduct construction over Railway Christmas Day - Boxing Day 2020
Bartle Lane Bridge Summer 2021 - Summer 2022
East West Link Road Summer 2021 - Summer 2022
Cottam Link Road Autumn 2021 - Autumn 2022
Road open Spring 2023

As the working age population in Lancashire is decreasing, we need to build on the sustained economic growth to keep young people in the area and bring in more skilled workers.

The transport network serving Preston and the wider area is also becoming increasingly congested.

We need to make sure that the road infrastructure supports our ambitious plans across North West Preston including 5,500 new homes.

Building new road capacity will:

  • Provide direct access to new housing developments.
  • Provide an alternative to avoid rush hour traffic in the city centre
  • Improve access to the motorway from the Enterprise Zone at Warton.
  • Improve our existing roads and local centres.
  • Help to prioritise and promote walking and cycling.
  • Support delivery of a new parkway rail station at Cottam.

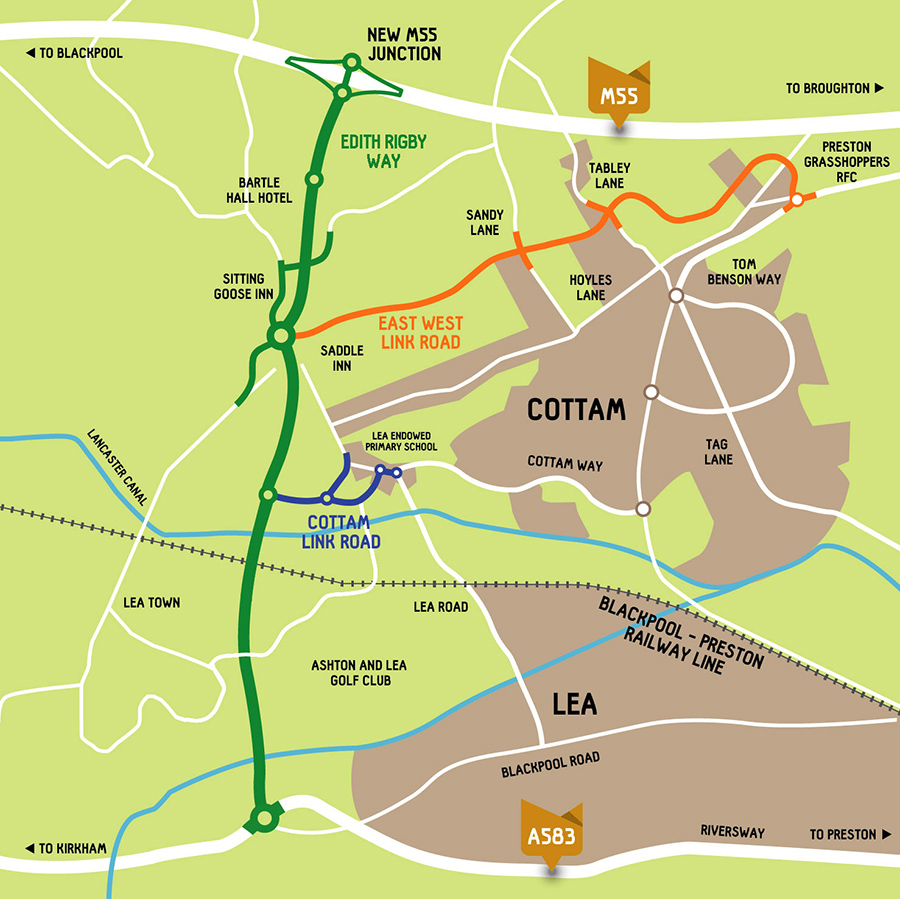

Preston Western Distributor
